Insurance Reconstruction & Repairs in San Diego

Reconstruction is the majority of what we do. Roughly nine out of ten dollars CCR earns comes from putting buildings back together, not from the emergency work that precedes it.

That matters to you for one specific reason. Most restoration companies dry the building, clean it, and hand you a referral to a general contractor. That handoff is where projects stall, where scope gets lost between two companies, and where nobody is accountable for the finished result.

We do both halves. The crew that shows up the night of the loss belongs to the same company that hands the building back to you finished.

Get Help Now!

By submitting my data I agree to be contacted

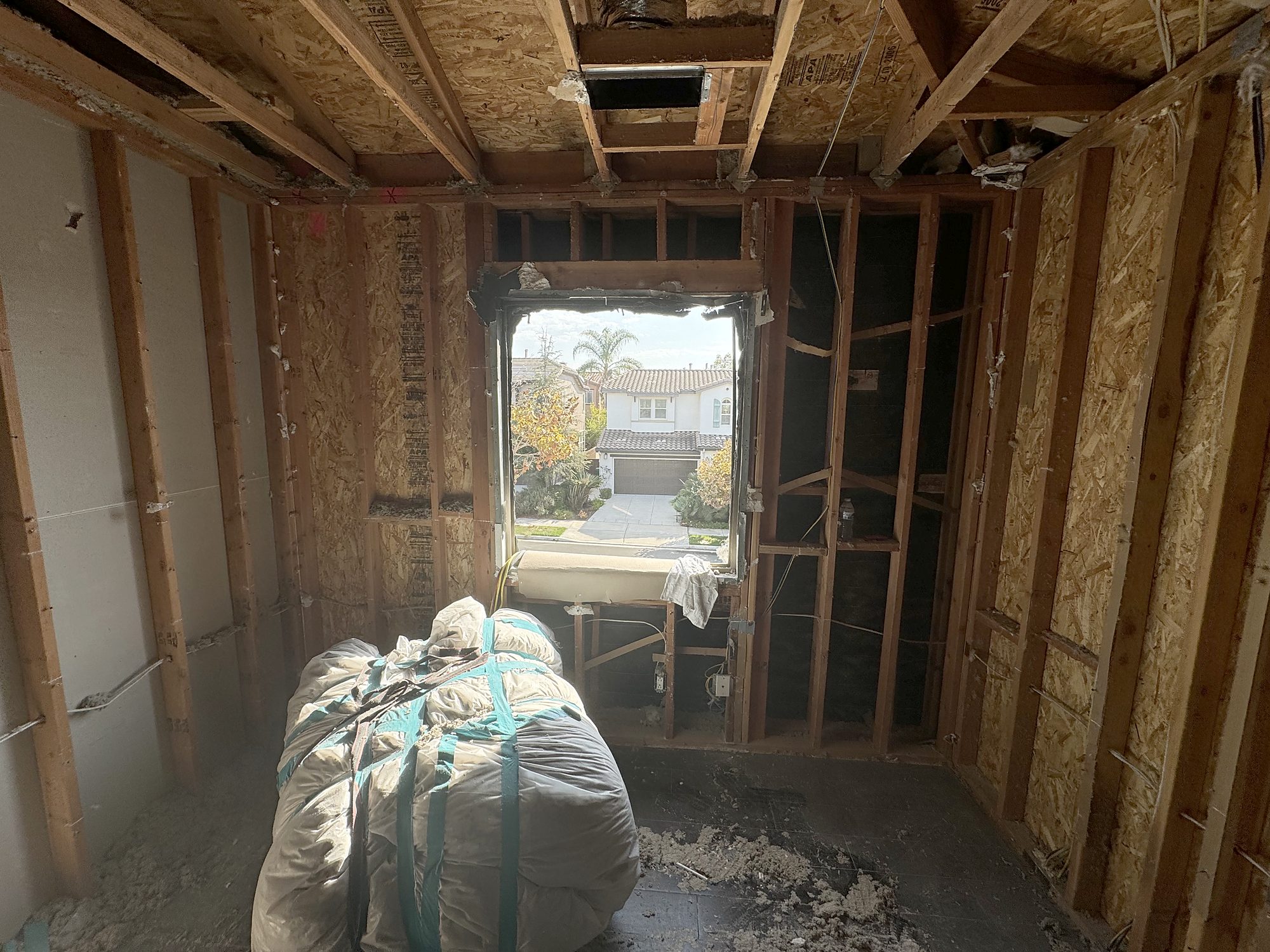

Bedroom taken down to framing and sheathing during reconstruction of a fire-damaged San Diego home

Mitigation and Rebuild Under One Contract

Why the Handoff Costs You

When mitigation and reconstruction are two different companies, three things reliably go wrong.

Scope falls through the gap. The mitigation company documents what they removed. The contractor estimates what they will rebuild. Anything neither one clearly owns becomes an argument later, usually with you in the middle.

Time is lost twice. You wait for the mitigation company to finish, then you start over finding, scheduling, and contracting a builder, often at the back of their queue.

Accountability disappears. If something does not match or does not work, each company can point at the other.

Under one contract, the demolition is done by people who already know what is going back in.

Licensed, bonded, and insured. California contractor’s license #813685.

What one contract actually means:

  • One estimate covering emergency work through final finishes
  • One point of contact rather than two companies and an adjuster
  • Demolition performed by people who know what is going back in
  • No gap between mitigation completing and construction starting
  • One company accountable for the finished result

What Reconstruction Covers

  • Framing, structural repairs, and load-bearing work
  • Roofing coordination, exterior envelope, stucco and siding
  • Drywall, texture, paint, and finish carpentry
  • Kitchens, bathrooms, cabinetry, countertops, and tile
  • Flooring across all substrates
  • Electrical, plumbing, and HVAC through licensed trades we manage
  • Commercial tenant improvements and buildouts

Whether the loss was water, fire, storm, or a vehicle through the wall, the rebuild is the same discipline.

How a rebuild runs:

Scope – Written in Xactimate, the platform your carrier and adjuster already use, so it can be reviewed and agreed rather than argued.

Approval – Carrier review. Usually the least predictable phase of the whole project.

Build – Framing, envelope, mechanical trades, then finishes.

Supplement as needed – Hidden damage documented and submitted as it is uncovered.

Completion – Final walkthrough, punch list, and invoicing that supports release of your recoverable depreciation.

How an Insurance Rebuild Actually Gets Paid

This is the part almost nobody explains, and it is the reason people feel misled by their own insurance.

Most policies pay replacement cost value, but they do not pay it all at once. The carrier first issues actual cash value – the replacement cost minus depreciation for age and wear. The difference is held back as recoverable depreciation, and it is released only after the work is actually completed and invoiced.

So the first check is deliberately short. It is not a lowball and it is not the settlement. It is a partial payment with the balance conditional on the repairs being done.

Two consequences worth understanding. If you pocket the first check and do not rebuild, you forfeit the recoverable depreciation. And if your property carries a mortgage, your lender is usually named on the check and will release funds in stages as work is inspected.

We invoice in a way that supports the depreciation release, because getting that second payment issued is part of the job.

Questions worth asking your adjuster early:

  • Is this settled at replacement cost or actual cash value?
  • How much is being held as recoverable depreciation?
  • Do I have ordinance or law coverage, and at what limit?
  • Is my mortgage company named on the payment?
  • What is the deadline for completing repairs to recover depreciation?

The last one catches people. Recoverable depreciation is usually time-limited.

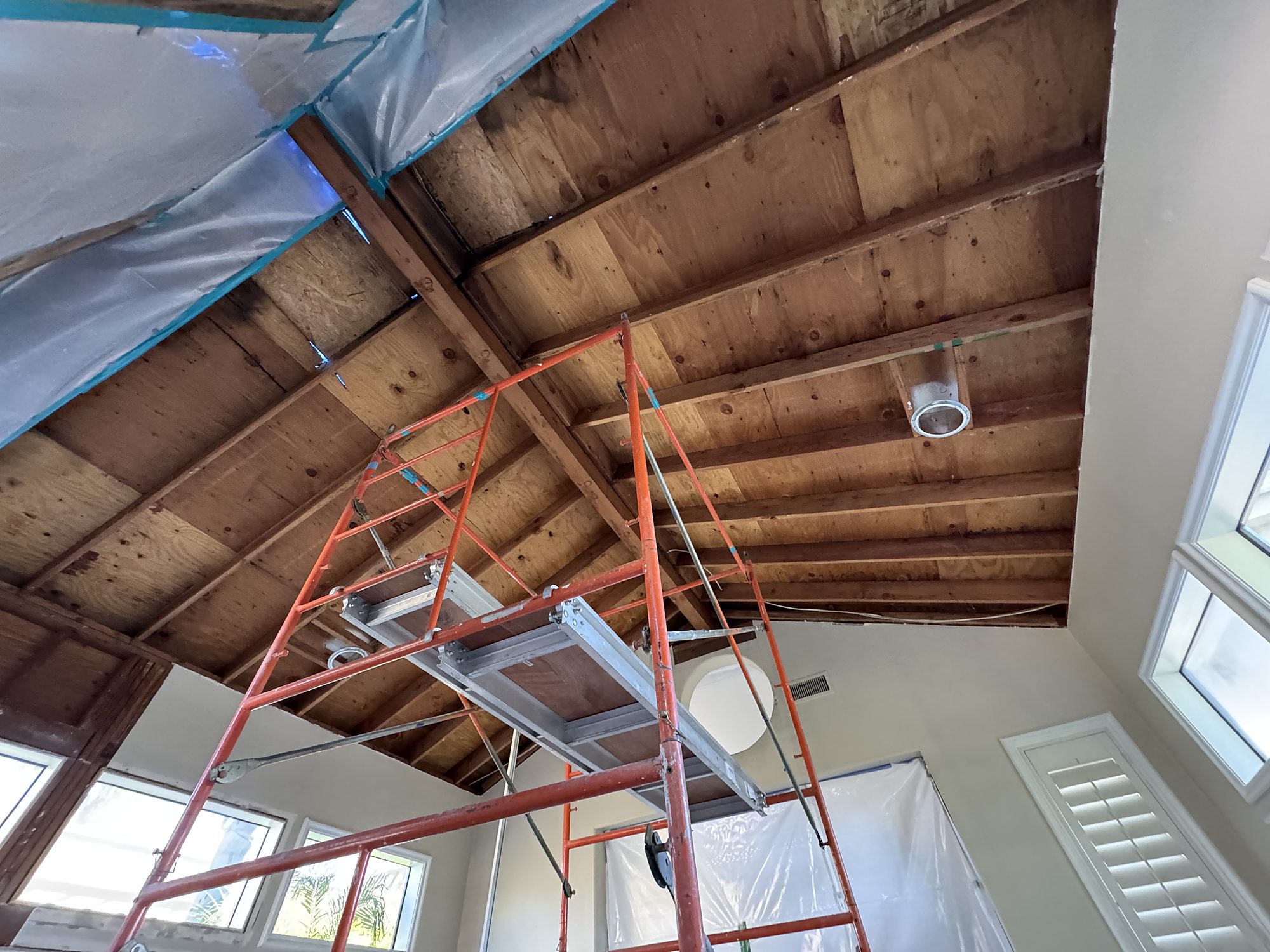

Exposed vaulted ceiling framing during reconstruction of a fire-damaged San Diego home

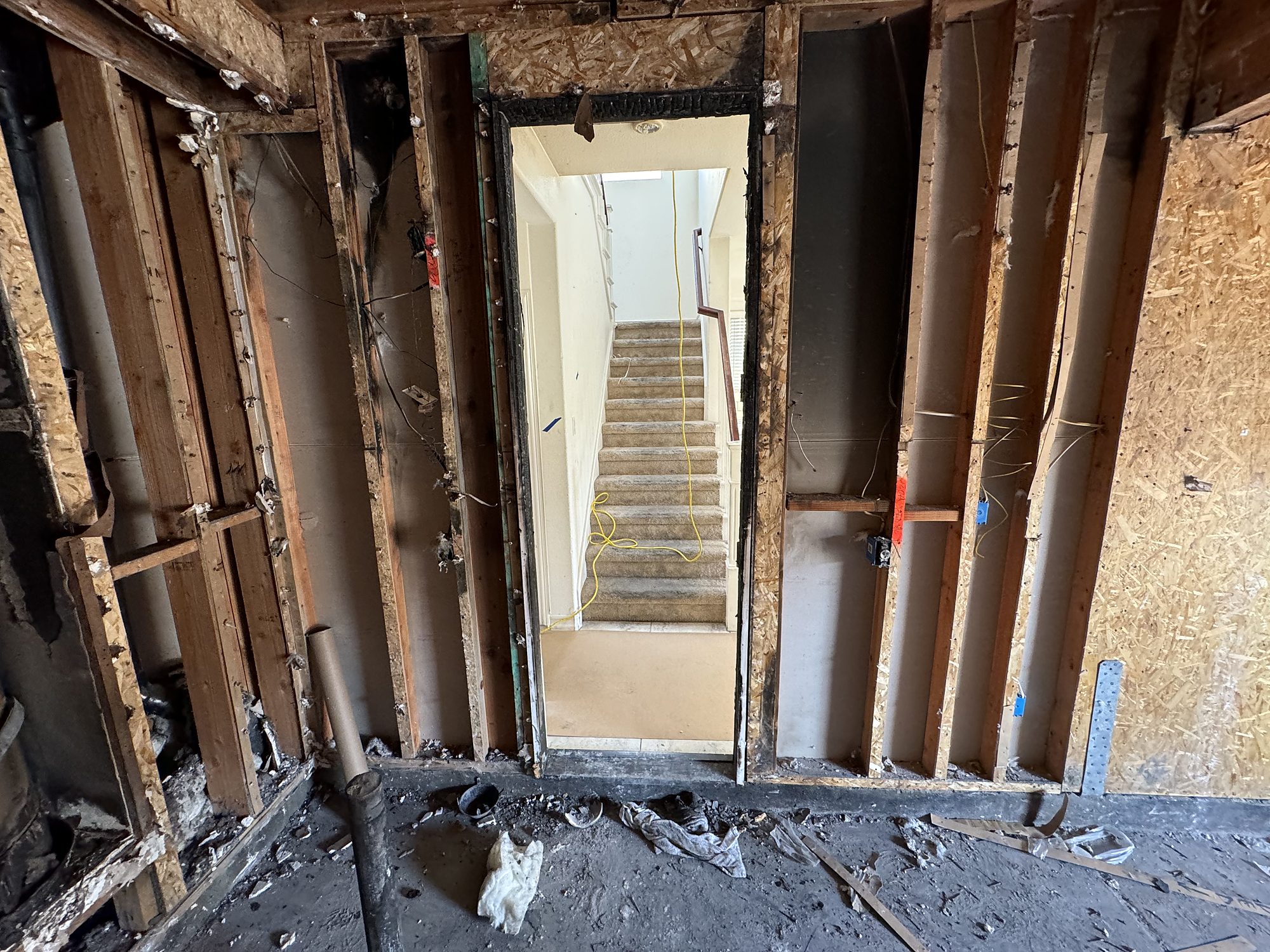

Framed doorway between a fire-damaged room and an undamaged stairwell during reconstruction in San Diego

Supplements: What Happens When the Damage Is Worse Than the Scope

A scope written before demolition is a scope written blind.

The estimate your adjuster approves is based on what could be seen. Once walls open, we routinely find damage that was not visible: water that travelled further than the staining showed, charring inside a wall cavity, compromised framing, or failed materials behind a finish.

When that happens, the work needs a supplement – a documented request to expand the approved scope and budget before proceeding. This is normal and expected on any real loss. It is also where jobs stall, because a supplement submitted with thin documentation gets questioned, and the building sits.

We photograph and document conditions as they are uncovered and submit supplements in the format adjusters expect. That is the difference between a two-week pause and a two-day one.

Reconstruction Is Our Core Business – About 90% of our work, not a service line we added

Single Contract – Mitigation through final finishes, no handoff

Over 20 Years in San Diego – Founded 2001, family owned and operated

An IICRC-Certified Firm – Four certified technicians on staff

Claims Fluency – Xactimate scoping, documented supplements, invoicing built to release depreciation

Approved Vendor on 10+ Carrier Programs – We are not permitted to name them here, but adjusters know us

Top Performer & Golden Hammer Awards – Multiple-time winner, scored on service, quality, and communication

Licensed, Bonded, and Insured – California contractor’s license #813685

Code Upgrades and the Matching Problem

Code Upgrades

Buildings are repaired to today’s code, not the code that existed when they were built. On an older San Diego property that can mean electrical, egress, insulation, or structural requirements the original building never had to meet.

Standard policies generally cover restoring what was there, not upgrading it. Coverage for the difference comes from ordinance or law coverage, which many policies include at a limited percentage and some exclude entirely. It is worth knowing which you have before the rebuild starts rather than discovering it mid-project.

The Matching Problem

Damage stops at a line. Finishes do not.

If flooring runs continuously from the damaged room into two undamaged ones, replacing only the damaged section leaves a visible seam and a mismatch. Carriers and policyholders disagree about this constantly, and outcomes vary by policy language and by how the request is documented.

We document continuous surfaces and line of sight explicitly when scoping, because a matching argument made at the start with photographs is far more likely to succeed than one made at the end with frustration.

CCR technicians laying floor protection over hardwood before starting interior work in a San Diego home

Insurance Reconstruction: Common Questions

A remodel is a negotiation between you and a builder. An insurance rebuild is a negotiation between a builder and your carrier, with you in the middle.

The scope is written in Xactimate, the estimating platform carriers use, and it has to be justified line by line rather than quoted as a lump sum. Materials are specified to restore what was there rather than to your preference. And the work cannot simply start when you are ready, because it starts when the carrier approves.

It is a different discipline, and a builder who only does retail remodels will often struggle with the documentation side even if the carpentry is excellent.

Because it is not the settlement. It is the first of two payments.

Most policies settle at replacement cost but pay actual cash value first, which is replacement cost minus depreciation for age and wear. The withheld portion is called recoverable depreciation, and the carrier releases it after the work is completed and invoiced.

So the small check is by design. The balance is real, but it is conditional on the repairs actually happening.

You can generally keep the actual cash value payment, but you forfeit the recoverable depreciation, which is often the larger half.

Two other things usually get in the way. If you have a mortgage, your lender is typically named on the check and releases funds in stages as work is inspected, so the money is not freely yours. And unrepaired damage on record can affect your future coverage and your eventual sale.

There are situations where taking the ACV and moving on is the right decision. It is worth making it deliberately rather than by accident.

A supplement is a documented request to expand the approved scope after hidden damage is found.

The original estimate was written before anything was opened up, based on what could be seen. Once demolition starts, additional damage frequently appears: water further than the staining showed, charring inside a cavity, or compromised framing.

The work cannot proceed past approved scope without authorization, so the project pauses while the supplement is reviewed. How long that pause lasts depends almost entirely on how well it was documented. We photograph conditions as they are uncovered and submit in the format adjusters expect, which is what keeps a pause to days rather than weeks.

This is the matching problem, and it is one of the most commonly disputed parts of a rebuild.

Damage stops at a line but finishes do not. If flooring, cabinetry, or countertops run continuously into undamaged areas, replacing only the damaged portion leaves a visible mismatch. Whether the carrier pays to extend depends on your policy language, on the continuity of the surface, and heavily on how the request is documented.

We photograph continuous surfaces and line of sight during scoping and raise matching at the start. Made early with evidence, it succeeds far more often than raised at the end as a complaint.

Only if you have ordinance or law coverage, and only up to its limit.

Repairs must meet today’s code, but a standard policy covers restoring what was there, not upgrading it. On an older property the gap can be significant – electrical, egress, insulation, or structural requirements the original building never had to satisfy.

Many policies include ordinance or law coverage at a limited percentage; some exclude it entirely. Ask your adjuster before the rebuild starts. Finding out mid-project is how budgets break.

The build itself is usually the predictable part. Carrier approval is not.

A contained single-room rebuild might run a few weeks once approved. A full structural rebuild after a large fire runs months. What moves that range most is not our schedule, it is how quickly scope is agreed and how many supplements the job generates.

We can give you a realistic timeline after the scope is written, and we will tell you which parts are within our control and which are not.

Yes, and it is often the most cost-effective moment to do it, because the demolition and access are already paid for by the claim.

The important part is bookkeeping. Claim scope and owner-requested upgrades are tracked and invoiced separately, so your carrier sees a clean restoration scope and you see exactly what the upgrade cost you. Blending them creates problems for both the claim and your understanding of what you spent.

Tell us early. Deciding to upgrade a kitchen layout after the drywall is up costs far more than deciding before framing.


Contact CCR for Reconstruction in San Diego

If your property needs to be rebuilt after a loss, the useful conversation starts with the scope, not the schedule. Call CCR Construction at 858-397-2270 to talk through what your carrier has approved and what it will actually take.

We handle mitigation and reconstruction under one contract, work directly with your carrier, and stay accountable for the finished result, because we are the ones who finish it.

Get Help Now!

By submitting my data I agree to be contacted
